Case Study · Consumer Goods Supply Chain

Pack at the Plant, or Pack at the DC?
Where Packaging and Cycle Stock Belong in a Consumer Goods Network

A US consumer goods manufacturer made bulk product on cycles as long as 91 days and packed it at the plant, so every run became weeks of finished goods allocated on a forecast. Moving packing downstream to the distribution centers looked like the fix. A model of the whole network showed it was the right answer for some product categories and the wrong one for others, and it showed which were which.

Sector
Consumer goods
The decisions
Where to pack, and where to hold cycle stock
Scope
Plants, distribution centers and customer-facing inventory
What it was worth
A category-by-category policy instead of a network-wide guess
Evidence
Project record, original model output

Long production cycles, packed too early

The bulk material was made at the plants on cycles of 7, 14, 28 or as many as 91 days. Each production run was immediately allocated to packaging runs of finished items. Packing at the plant turned every long run into a large block of finished-goods cycle stock, and the forecast decided which item and which distribution center each case went to.

When the forecast was wrong, the cost showed up twice. Bulk was packed into the wrong items, and finished goods were shipped to the wrong distribution centers and had to be redeployed between them. Stock that waited too long aged out and was thrown away.

Two questions from the same network

The work answered two related questions, each with its own model built on the same inputs: historical forecast and demand, and production rates by system and product.

QuestionAlternativesExperiment factors
Where should packing happen?Pack at the plant, or ship bulk to the distribution centers and pack there weekly against next week’s local forecastReorder policy; which product categories to pack downstream
Where should cycle stock sit?Push each run out to the distribution centers, or hold it at the plant until a distribution center reordersReorder policy; which product categories to push downstream

Both models were scored the same way: total inventory, finished-goods inventory, bulk inventory, customer order fill rate, redeployment cost and disposal cost for aged product.

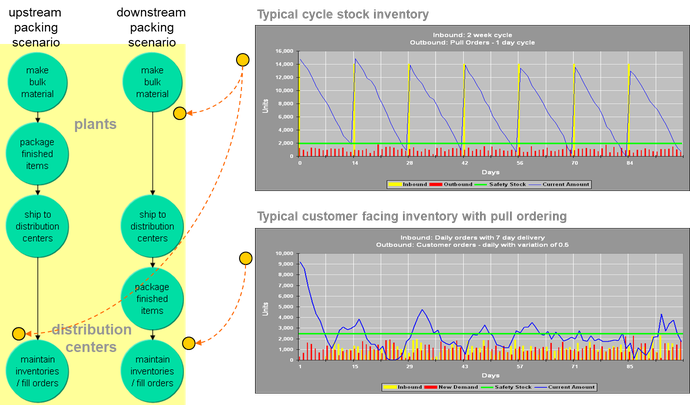

Left: the two scenarios side by side. Upstream packing runs make bulk, package, ship to distribution centers, then hold inventory and fill orders. Downstream packing makes bulk, ships it, and packages at the distribution center before holding inventory. Right: two model plots over about 90 days. Cycle stock inventory saws from about 14,000 units down to near zero on a two-week inbound cycle, while customer-facing inventory under pull ordering fluctuates between about 1,000 and 5,000 units around a safety stock line.
The two packing scenarios, and original model output from one item: cycle stock on a two-week production cycle (top) and the customer-facing inventory it feeds under daily pull ordering (bottom).

What packing downstream traded

Packing weekly at the distribution center, against that location’s own forecast for the next week, almost eliminated finished-goods cycle stock. It also ended redeployment of finished product from one distribution center to another. Customer service held.

The price was a new kind of inventory. Bulk material now had to sit at the plants until it was pulled, and again at each distribution center until it was packed.

Pack at the plantPack at the distribution center
GainsNo bulk inventory anywhere; it becomes finished items as it is madeFinished items packed weekly close to demand, which limits the damage from forecast error. No redeployment between distribution centers.
CostsBulk allocated to items on a forecast, and items allocated to distribution centers on a forecast. Misallocation means redeployment.Bulk inventory at plants and at every distribution center, which can raise total inventory cost

For many product categories, the new bulk inventory canceled out the gains. For others it did not. Because the model ran item by item, the answer was not “pack downstream” or “don’t”. It was a list of categories worth moving, and the rest left where they were.

Where cycle stock should sit

The second model asked a related question: with long production cycles, should each run be pushed out to the distribution centers, or held at the plant and released only when a distribution center reorders?

Pushing cycle stock downstream looks protective, because it tops up safety stock at the locations facing customers. The model showed the other side. When a run was misallocated, some distribution centers ran out early while others still held plenty, and moving stock between them was not always feasible. The shortage then triggered the next production run early, which is what long cycles exist to avoid.

Hold cycle stock at the plantPush cycle stock downstream
GainsLess redeployment for high-variability products; fewer early production triggersCycle stock at the distribution center protects its safety stock
CostsSafety stock at the distribution centers gets no help from cycle stockMisallocation leads to redeployment and early production triggers

The conclusion was to keep cycle stock upstream at the plants and fill the distribution centers on a pull basis. The same held for the bulk material shipped downstream in the packing scenarios.

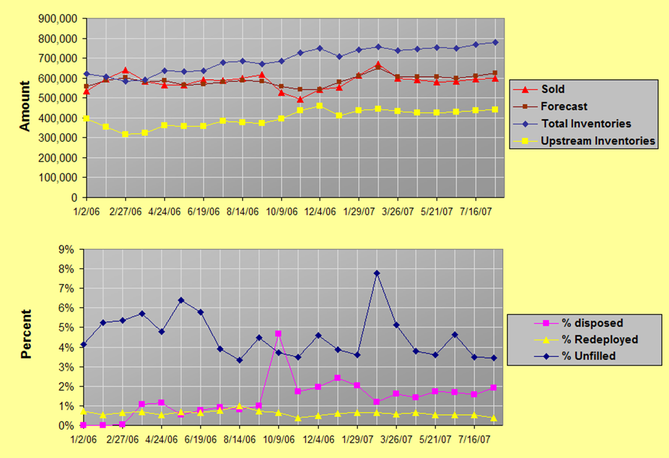

Two model output charts over about 20 months. Top: units sold, forecast, total inventories and upstream inventories. Total inventory runs from about 600,000 to 780,000 units and upstream inventory from about 320,000 to 460,000. Bottom: percent of demand disposed, redeployed and unfilled. Unfilled runs between about 3.5 and 8 percent, disposed rises to a peak near 4.7 percent, and redeployed stays under 1 percent.
Original model output, all plants and all products for one scenario. The top chart tracks sales, forecast and inventory; the bottom tracks the share of demand that went unfilled, was redeployed or was disposed of. The same view was available for one plant, one category, one brand or one finished item.

Two findings that carry over

A textbook safety stock formula, adjusted, was accurate

A packing schedule fixed to once a week changes how much safety stock a location needs. The standard safety stock calculation, modified for that weekly schedule, predicted the model’s safety stock requirements at the customer-facing inventories accurately. That is a useful result on its own: the simulation confirmed a formula the planners could keep using without the model.

Capacity shortfalls had a defined order of response

When a plant could not keep up with demand, the first response was to move that demand to another, less efficient plant. Only when capacity fell short across the whole system did the model schedule prebuilds.

Where this sits in ReliaSim

The question joins the plant and the network. Production run length is a plant decision, and redeployment, fill rate and disposal are network outcomes, so a model that holds only one side cannot answer it. That combination is what ReliaSim’s supply chain modeling is built for: production runs at the plant feeding demand, inventory and ordering across the network, in one model.

The simplest version of the question, where to hold safety stock across a multi-tier network, runs in the browser today.
